Las Vegas, NV · EV charging infrastructure · Design–build

The hard part isn't the charger.
It's the power behind it.

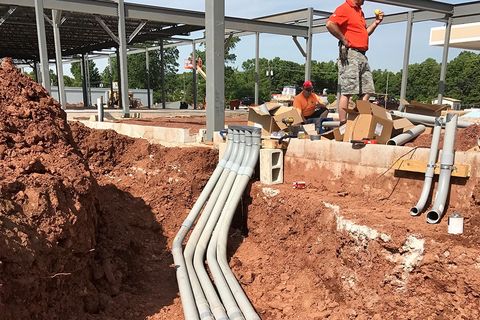

Chargtek surveys, designs, permits and builds DC fast-charging sites — utility service, switchgear, conduit, foundations, dispensers and commissioning. We keep the trench short with horizontal directional drilling, and we size the ground for the power levels arriving now, not the ones that shipped in 2019.

Where your site lands on the power curve Logarithmic scale · kW delivered per port
7.2kW
Level 2 AC
Overnight · workplace
50kW
Legacy DC
Being retired
150kW
DC fast
Volume tier
350kW
High power
Highway standard
1,000kW
1,000 V class
10–70% in ~5 min
3,750kW
MCS ceiling
Class 8 · transit
  • 3,750 kWMegawatt Charging System ceiling — Class 8, transit, marine
  • 1,000 kW1,000 V architectures — 10–70% in about five minutes
  • 350 kWHigh power — current highway standard

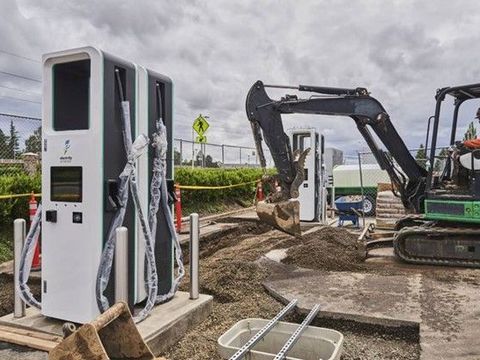

  • 150 kWDC fast — today's volume tier
  • 50 kWLegacy DC — being retired from public networks
  • 7.2 kWLevel 2 AC — overnight, workplace, multifamily
Chargtek design–build scope Level 2 through megawatt
NACS / SAE J3400CCS1 dual-standardISO 15118-20 Plug & Charge OCPP 2.0.1IEC 63379 — MCS1,000 V DC architecture V1G / V2G managed chargingUL 2202 · UL 2594NEC Article 625 ADA accessible charging

Free tool

Can your site support fast charging?

Service size in, verdict out — with the arithmetic shown line by line. Two minutes, no signup.

Run the feasibility check

Capability

Self-perform, end to end.

HDD in-houseDirectional drilling crews on our payroll, not a sub's schedule
Self-perform electricalService, switchgear and dispenser terminations by our own electricians
Utility interfaceMake-ready and interconnection filings run by us, tracked weekly
Level 2 → megawattOne contractor across the whole power curve

OEM programs

Entering the North American market?

Vehicles arrive before infrastructure does. If you are launching a brand or electrifying a commercial line in the United States, the charging build is a construction problem long before it is a hardware problem — and it runs on utility timelines, not product timelines.

  • Delivery & dealer networks. Repeatable multi-site builds to one spec, market by market.
  • 1,000 V ready. Conductor, clearance and pad design that accepts megawatt-class cabinets without a second mobilization.
  • Dual-standard dispensing. NACS and CCS1 served from the same bay through the transition.
  • Utility interface. We run make-ready and interconnection — the item that actually sets your launch date.

Commonly asked

You've got questions.

How do I get power to my location?

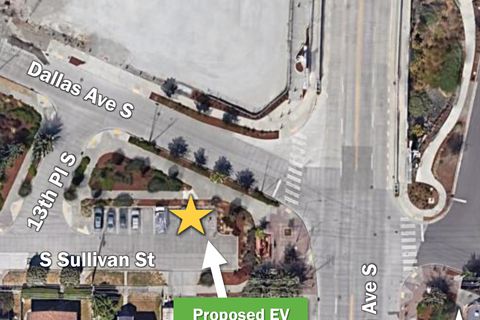

It starts with what's already at your property line. We pull the utility's available capacity for your service address, locate the nearest transformer with headroom, and determine whether you need a service upgrade, a new service, or simply a different point of connection. From there we file the make-ready and interconnection applications on your behalf. This step sets your schedule more than any other — which is why we do it first, not third.
Can my current location support a fast charger?
Frequently yes at a lower power level than you expect, and yes at full power with a service upgrade. A 150 kW dual-port cabinet needs roughly 200 kW of service headroom; a 350 kW bay needs considerably more. Behind-the-meter storage can bridge the gap where the utility can't. Run the two-minute feasibility check for a first read, then the free survey answers it for your exact address.
How many chargers should I install?
Fewer than you think on day one, with the ground built for more than you think by year five. Dwell time, traffic pattern and vehicle mix drive the port count; the expensive part — service, switchgear, conduit and foundations — is what you don't want to build twice. We routinely install four ports on a pad and pathway engineered for twelve.

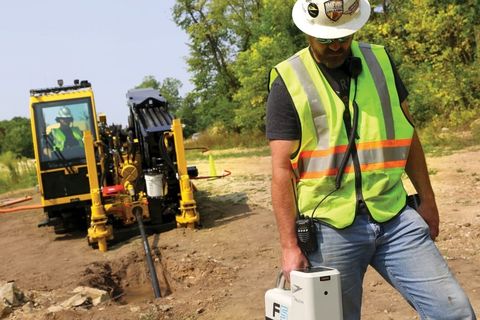

What does horizontal directional drilling change?

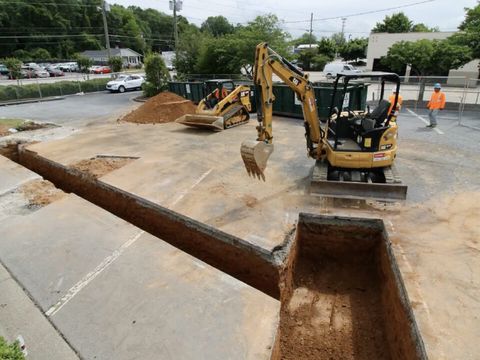

It means we can get power across a parking lot, driveway, landscaped area or active roadway without opening it. Less surface restoration, less downtime for your business, fewer permits in many jurisdictions, and a materially lower total cost on sites where the transformer is far from where the chargers need to go.
Do you build for heavy-duty and transit fleets?
Yes. Depot charging is a different discipline from public fast charging — sequenced charging across a whole yard, shift-pattern load profiles, and pathways staged for megawatt dispensers that may not be commercially available on the day we pour concrete. We design the civil and electrical infrastructure now so the upgrade later is a cabinet swap rather than a rebuild.
